To provide the Liquid Waste Committee with the priorities and work plan for the year 2019. Complete the Iona Island WWTP project definition including the development of the indicative design for the new plant. The priorities in the 2019 work plan of the Liquid Waste Committee correspond with the 2018 Budget approved by the GVS&DD Board on October 26, 2018 and with the most important actions included in the 2019 Annual Work Plans.

Inform the GVS&DD board of the current status of the North Shore Wastewater Treatment Plant Project. North Shore Wastewater Treatment Plant Liquid Waste Standing Committee Meeting Project Status Update Date: January 17, 2019 Page 2 of 4. Decommissioning of the existing Lions Gate Wastewater Treatment Plant (LGWWTP) and returning the land to the Squamish Nation.

North Shore Wastewater Treatment Plant Project Status Update Liquid Waste Committee Regular Meeting Date: January 17, 2019 Page 3 of 4 North Shore Wastewater Treatment Plant Project Status Update Liquid Waste Committee Regular Meeting Date: January 17, 2019 Page 4 of 4 Iona Island Wastewater Treatment Plant - Project Definition Update Liquid Waste Committee Regular meeting date: 17 January 2019 Page 2 of 3.

Iona Island Wastewater Treatment Plant – Project Definition Update Liquid Waste Committee Regular Meeting Date: January 17, 2019 Page 3 of 3 The purpose of this report is to inform the GVS&DD Board of the liquid waste capital projects under its purview for 2019, as approved by the Board on Oct 26, 2018. For 2019, liquid waste capital projects account for approximately $564.8 million of the 2019 Metro Vancouver capital budget.

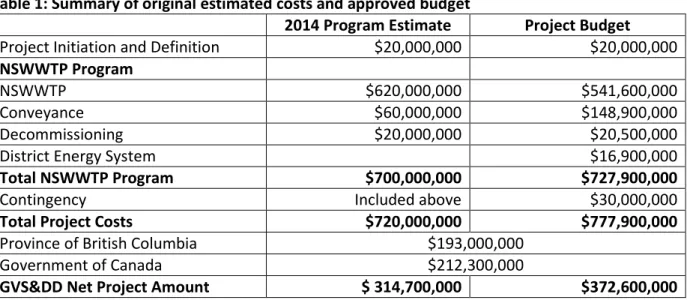

Table 1 provides a summary of the estimated costs of the program in 2014. The table also shows the  current approved budget for the entire program to completion
Table 1 provides a summary of the estimated costs of the program in 2014. The table also shows the current approved budget for the entire program to completion

City of Vancouver

City of Richmond

City of Delta

City of Surrey

Township of Langley

Langley

City of Maple Ridge

City of MeadowsPitt

CoquitlamCity of

Coquitlam

City of New Westminster

Burnaby

City of Port Moody

Village of Anmore

Belcarra City of

North Vancouver

Municipality

Electoral Area A

District of North

Tsawwassen First Nation

2019 Liquid Waste Capital New Projects

Flow control of the secondary treatment device - Construction phase 2 - Replacement of the secondary effluent flow meter - Design - Layout of the construction site - Design. Replacement of 25 kV Substations - Design and Construction - CDAC System Hardware Upgrade - Design and Construction - Ground Improvements - Phase 1 Construction. Dewatering facility for biosolids - Design, construction phase 1 and preliminary design - Relocation of biogas pipes - Design and construction.

Aeration / Sedimentation Tank & Gallery Wall Renovation -Detailed Design - Replacement of Cogen Control System - Design & Construction. Electrical Distribution System Protection Control and Monitoring -Detailed Design - Fiber Optic Infrastructure - Detailed Design / Construction. Gravity Thickener and Dissolved Air Flotation Steel Repair and Coating - Hydrothermal Treatment Pilot - Design & Construction.

Remediation of walkways and columns of primary sedimentation tanks - Construction - Replacement of CDAC equipment in galleries - Design and construction. Secondary Clarifier Corrosion Repair and Leveling Phase 2 - Design, Pre-Procurement and Construction - Secondary Clarifier Flow Balancing - Construction. Golden Ears Sanitary Sewer Overflow Storage - Property Design and Acquisition - Golden Ears Forcemain and River Crossing - Preliminary Design.

2019 Liquid Waste Capital Approved in Progress Projects

Metro Vancouver Liquid Waste System

Legend

Subject: RE: Extension of the Comprehensive Review Cycle - GVS&DD Integrated Liquid Waste and Resource Management Plan. Greg Moore, former President of the Metro Vancouver Regional District, regarding the request to extend the Integrated Liquid Waste and Resource Management Plan (ILWRMP) comprehensive review cycle. Metro Vancouver's ILWRMP under the Environmental Management Act is central to ensuring that the joint management of municipal wastewater and stormwater discharges in local watersheds continues to be innovative and forward-looking in the management of British Columbia and Metro Vancouver.

When Ministry staff reviewed your request, I asked them to contact Metro Vancouver staff directly to discuss matters that could revitalize oversight of the existing plan and ensure the comprehensive plan review is successful set up. Peoples, public transparency on existing water quality issues and leadership on emerging issues such as microplastics and personal care products. I expect discussions with staff to continue in early 2019 and I hope to be able to make a decision on your extension request in the spring of 2019.

Cp: ​​Downie, AJ ENV:EX; Vroom, Bryan ENV:EX; Moore Chair; Carol Mason; Peter returned. Subject: Extension of the comprehensive review cycle - GVS&DD Integrated plan for the management of liquid waste and resources. Please find attached correspondence on behalf of Chairman Moore regarding the extension of the Comprehensive Review Cycle - GVS&DD Integrated Liquid Waste and Resource Management Plan.

The Honorable George Heyman, Ministry of Environment and Climate Change Strategy Expansion of Comprehensive Review Cycle - GVS&DD Integrated Liquid Waste and Resource Management Plan Page 2 of 2. Carol Mason, Commissioner and Chief Administrative Officer, Metro Vancouver Peter Navratil, General Manager, Liquid Waste Services, Metro Vancouver. To seek Council approval to submit a request to the Minister for the Environment and Climate Change Strategy to extend the ILWRMP comprehensive review cycle.

Expanding the ILWRMP's comprehensive review cycle will allow review and update of the plan to be aligned with the results of key initiatives related to the Iona Island Wastewater Treatment Plant's secondary upgrades, sewer overflow management, and climate change measures. The ILWRMP is the liquid waste management plan for GVS&DD and its members. Liquid waste management plans are used in the Environmental Management Act for Complex Liquid Waste Systems to issue operating certificates for waste water treatment plants as well as to define actions for local authority liquid waste systems that align with the Department for the Environment and Climate Change Strategy's objectives.

Once approved by the Minister for the Environment and Climate Change Strategy, a Liquid Waste Management Plan becomes the regulatory instrument under the Environmental Management Act. Under Action 3.5.7 of the plan, Metro Vancouver and its members are currently required to undertake a comprehensive review of the plan every eight years. Extension of the Comprehensive Review Cycle - Integrated Liquid Waste Plan and Resource Management Plan Services Committee Regular Meeting: September 20, 2018 Page 2 of 3.

Updating the ILWRMP through comprehensive review can align with strategies and actions to address climate change challenges as identified in the Climate 2050 work being undertaken in 2019 and 2020. Report progress and status of ILWRMP implementation of Metro Vancouver members and GVS&DD every two years in the Ministry of Environment and Climate Change Strategy. That the GVS&DD Board request the Minister of Environment and Climate Change Strategy to extend the ILWRMP comprehensive review cycle from eight to ten years and direct staff to post notice of the request in newspapers and on the Metro Vancouver website.

That Council not request an extension of the ILWRMP's comprehensive review cycle and direct staff to undertake the comprehensive plan review beginning in 2019. The only financial and resource implications for these alternatives relate to the timing of the ILWRMP's comprehensive review and the allocation of staff and resources for the review. This will enable a better informed comprehensive review of the plan by allowing time to further advance key initiatives and align with their outcomes.

Figure

Table 1 provides a summary of the estimated costs of the program in 2014. The table also shows the  current approved budget for the entire program to completion
