The existing Employee Benefits standards in PS 3250, Retirement Benefits and PS 3255, Post-Employment Benefits are among the older standards that currently exist in the PSA handbook. To provide an update on the work of the Project Delivery Department in relation to the development and deployment of Best Practice for Project Delivery in the area of project costing. Cost estimating is the forecasting of the cost of the project, from inception to project completion.
ATTACHMENT

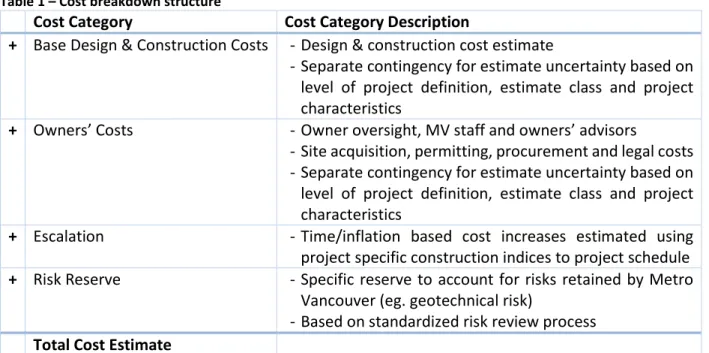

Standardized Cost Categorization
A separate contingency for estimate uncertainty based on project definition level, estimate class, and project characteristics. Site acquisition, permitting, procurement and legal costs - separate assessment uncertainty contingencies based on project definition level, assessment class and project characteristics. Escalation – Time/inflation based cost increases estimated using project specific construction indices in the project schedule + Risk Reserve – A special reserve to account for risks retained by Metro.
Project Implementation Best Practice Response - Project Assessment Framework Date of Finance and Intergovernmental Committee Regular Meeting: 18 November 2020 Page 3 of 4 The baseline design and construction cost estimate includes a separate uncertainty assessment line item to allow for design refinement and assumption assessment, when the scope is further defined throughout the life cycle. This allows the level of scope definition, the complexity of the project and the novelty of the scope of work or implementation model to be taken into account;.
The proprietary cost estimate also includes a separate line item for uncertainty estimation, which allows assumptions to be evaluated as the site and control model are further defined throughout the life cycle. A separate risk reserve covers risks owned by Metro Vancouver that are identified, managed and quantified in accordance with a standardized risk review process. Having a separate risk reserve encourages a thorough consideration of systemic and project-specific risks and can be used in evaluating the procurement and risk allocation model.

Consistent Guidelines Throughout the Project Lifecycle
Response to Project Delivery Best Practices – Project Estimating Framework Regular Meeting of the Financial and Intergovernmental Commission Date: November 18, 2020 Page 4 of 4. The guidelines described above have been developed using the Association for the Advancement of Cost Engineering International's estimating classification system ( AACEi). The classification system includes five estimation classes, from class 5, which corresponds to the lowest project definition, to class 1, which corresponds to the highest project definition.

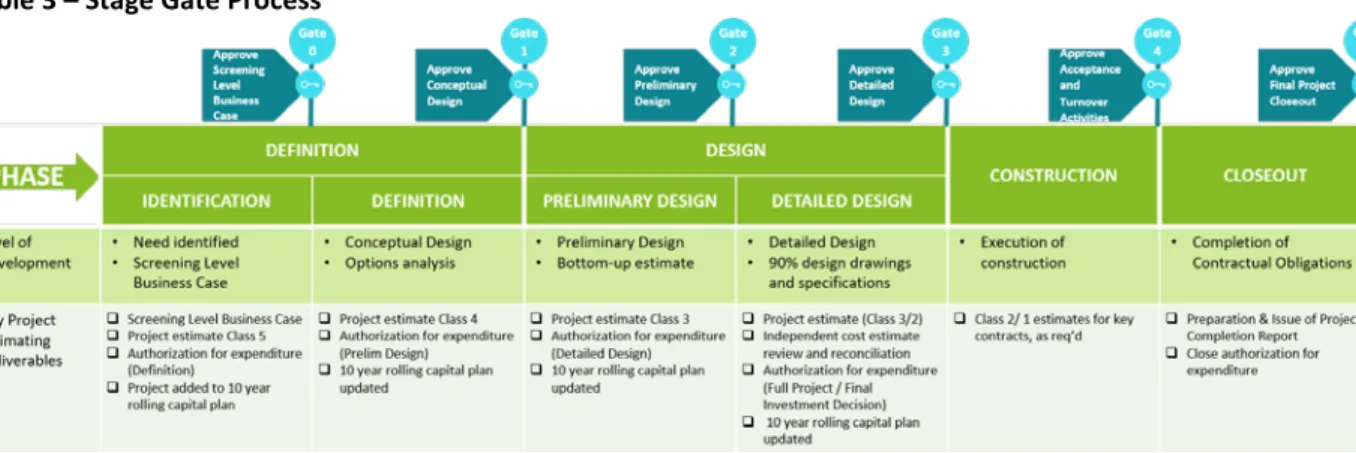

Formalized Cost and Scope Stage Gate Process
That the Performance and Audit Committee receives for its information the report dated January 4, 2021 entitled "Tender/Contract Award Information - September 2020 to November 2020". In addition, there were seven (7) existing contracts that required contract amendments, necessitating additional reporting to the Performance and Audit Committee. 500,000 will be reported to the Performance and Audit Committee to align with the thresholds outlined in the policy.
The following contracts were awarded during the months of September 2020 to November 2020 (details attached as ANNEX A):. Tender/Contract Award Information – September 2020 to November 2020 Regular Performance and Audit Committee Meeting: January 14, 2021 Page 2 of 5. WSP Canada Group Limited, Associated Engineering. Tender/contract award information – September 2020 to November 2020 Date of regular meeting of the Performance and Audit Committee: January 14, 2021 Page 3 of 5.
Information on Tender/Contract Award – September 2020 to November 2020 Performance and Audit Committee Ordinary Meeting Date: January 14, 2021 Page 4 of 5 Information on Tender/Contract Award – September 2020 to November 2020 Performance and Audit Committee Ordinary Meeting Date: January 14, 2021 Page 5 of 5. APPENDIX B: Contract modified to a value of more than $500,000 but not previously reported to the Performance and Audit Committee.
